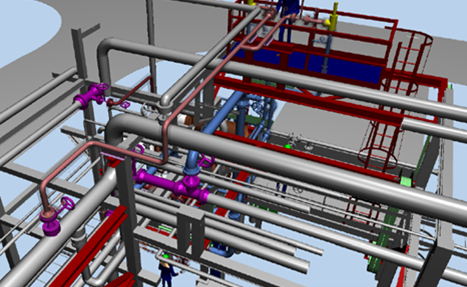

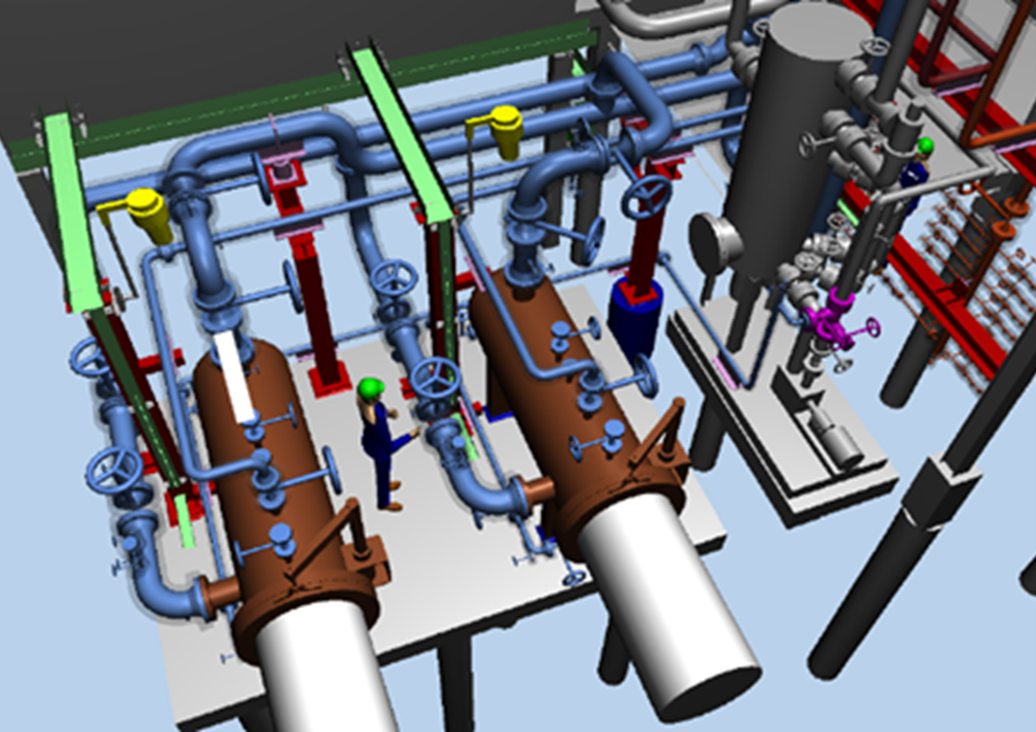

Rally, with the Client’s project team, identified potential filter vessel and piping tie-in locations. The team decided to mount the new filters on an abandoned tank foundation to save cost. With the aid of laser scanning, Rally optimized the location of tie-ins to the HNU process, flare, and slops systems.
Piping tie-ins were constructed during the next unit turnaround, while the filters were still being fabricated. After the new filters arrived on site, all of the adjacent piping, structural, electrical, and instrumentation work was done without needing another outage.
A material requisition (MR) was developed for the new filter vessels, with detailed data sheets, fabrication requirements, and inspection details.
CWPs were issued for turnaround piping tie-ins, post-turnaround piping and filter installation, steam tracing, concrete, steel, grout, electrical, and instrumentation.
Ready to work with the leading provider of engineering, procurement, and construction management services? Join Canada’s largest infrastructure-building companies, and partner with Rally today!
